Welcome to Public Works
Armando Gutierrez, Jr
Engineering and Public Works Director
Welcome! The Public Works Department is tasked with providing core community services and infrastructure maintenance that are key to the growth, health, safety and quality of life for the City of Brownsville. Visit this page frequently to learn about City projects and the latest updates..

CAPITAL IMPROVEMENT PLANS

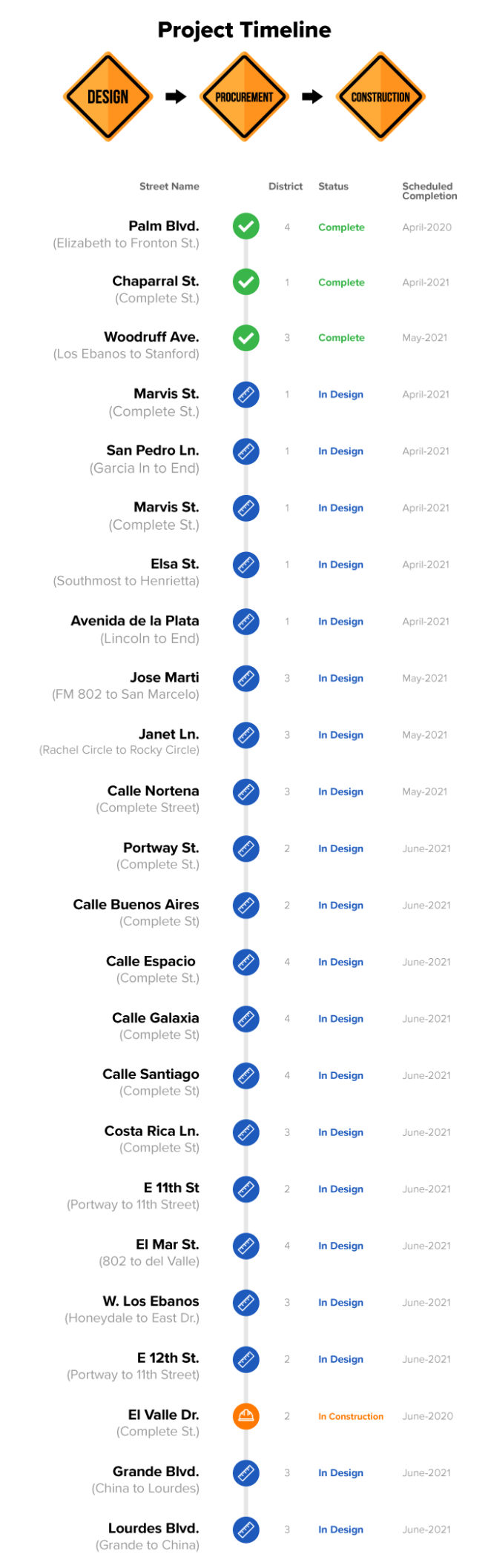

The balanced Fiscal Year 2020 budget supports $10.7 Million in capital improvement projects. The last time the City of Brownsville supported a CIP project of this magnitude was from 2002-2009, so our streets are getting quite a renovation in the years to come! The streets below have been selected for the CIP Street Improvement Program and will be reconstructed.
The Public Works Department has completed Palm Blvd from Elizabeth to Fronton St. as scheduled. In addition, we have completed Chaparral St. and Woodruff Ave. from Los Ebanos to Stanford, which were both scheduled for completion in the year 2021. Projects marked IN PROGRESS are in the design phase then will be followed by the procurement and construction phases.

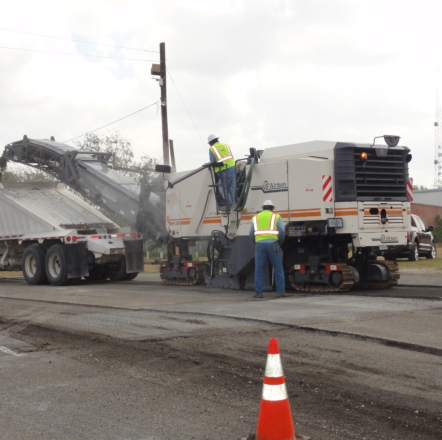

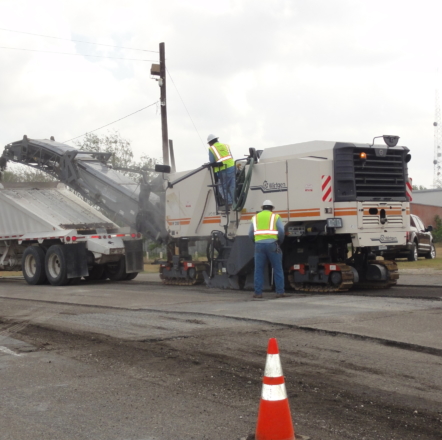

Palm Blvd Milling
The Public Works Department has completed Palm Blvd from Elizabeth to Fronton St. as scheduled.
In addition, they have completed Chaparral St. and Woodruff Ave. from Los Ebanos to Stanford, which were both scheduled for completion in the year 2021.
Projects marked IN PROGRESS are in the design phase then will be followed by the procurement and construction phases.

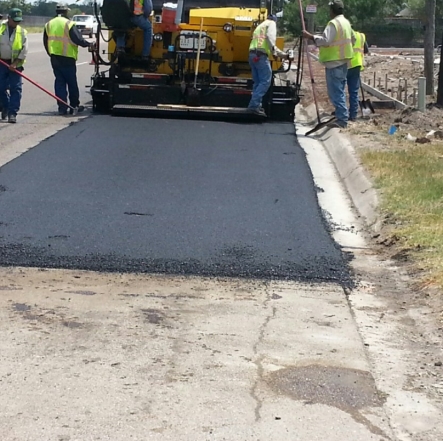

STREET MAINTENANCE
